Biogas plant project - Article featured image

Biogas Plant Project and Setup Cost: A Practical Guide to CapEx, Equipment and Development

Spread the love

Biogas plant setup cost is the cost of developing, building and commissioning a working anaerobic digestion facility—not simply buying a digester. A complete project budget must account for feedstock handling, civil works, process equipment, gas utilisation, digestate management, professional fees, connections and contingency. Initial working capital and financing requirements must also be considered, although these are not all capital expenditure.

The right budget depends on what the plant must do. A small household digester supplying cooking gas, a 250–500 kW farm plant generating electricity, a commercial food-waste facility and a biomethane plant injecting gas into a network are different projects with different costs.

This guide explains how to plan a biogas plant project, define its equipment and development scope, and build a realistic cost estimate. It takes a global perspective, with particular attention to commercial anaerobic digestion projects in the UK.

Key Takeaways

  • Biogas plant setup cost means more than the digester price. Include development, civil works, feedstock handling, gas utilisation, digestate management, connections and commissioning.
  • There is no universal price. Plant capacity, feedstocks, location, ground conditions and equipment scope determine the budget.
  • Compare quotations on the same basis. Check the price year, capacity, inclusions, exclusions and supplier responsibilities.
  • Separate CapEx, operating costs and total funding needs. Allow for contingency, financing and working capital through start-up.
  • A nearby electricity or gas network does not guarantee a connection. Confirm capacity, technical requirements, costs and timescales with the relevant operator.
  • Ground conditions, feedstock handling and connection delays can materially change project costs. Investigate them early and test their effect on the business case.

Table of Contents

How Much Does a Biogas Plant Cost?

There is no reliable universal price for a complete biogas plant. To obtain a meaningful estimate, specify the location, feedstocks, annual throughput, technology, energy output, site conditions and connection requirements.

A supplier’s equipment price may exclude substantial parts of the project. Equally, a published cost per kilowatt or cubic metre may describe a different plant type, price year or scope.

Before comparing biogas plant setup cost, establish whether each figure covers:

  • the digester alone;
  • a supplied process-equipment package;
  • an installed and commissioned plant;
  • the complete development, including site infrastructure and connections; or
  • the total funding needed to reach stable operation.

These figures are not interchangeable. A low equipment quotation can become an expensive project once reception buildings, foundations, digestate storage and energy connections are added.

Published benchmarks are useful as an initial cross-check. For example, IRENA’s Renewable Power Generation Costs in 2024 explains that installed bioenergy costs include engineering, construction, equipment and infrastructure. However, broad bioenergy figures include technologies other than anaerobic digestion and should not be treated as quotations for a particular AD plant.

Biogas plant project - Article featured image: Plan Design & Rough Cost Analysis.

Indicative Biogas Plant Setup Costs: Published Benchmarks

What order of investment should you expect? Published examples range from hundreds of US dollars for simple household digesters in particular developing-country settings to several million pounds for farm-scale electricity generation and tens of millions of euros for some commercial food-waste biomethane facilities.

The figures below provide reference points, not a universal price list. They describe different countries, capacities and project scopes. Historical figures have not been adjusted to 2026 prices, and the commercial examples should not be interpreted as complete funding budgets for your proposed site.

No recent, authoritative and publicly accessible schedule of directly comparable prices for England was identified. The sources checked included UK government material published by DESNZ and its predecessor departments, Green Gas Support Scheme documentation, and Defra’s anaerobic-digestion statistics. These sources provide scheme tariffs, deployment information and older cost models, but not a current market-price table for the items compared here.

The table therefore uses Northern Irish and Republic of Ireland figures as the closest available regional evidence. Northern Ireland forms part of the UK and uses pounds sterling, while Republic of Ireland prices are quoted in euros.

The figures are relevant because the markets are geographically close and some suppliers and specialist contractors operate across Britain and Ireland; nevertheless, they should be treated as indicative rather than assumed to be identical to English prices. VAT and taxation, grant support, labour and transport costs, grid-connection requirements, market scale and the precise scope of each quotation can all produce material differences.

At the time of writing (October 2026) €1 = £0.85.

Plant type and capacityPublished cost benchmarkGeography and dateHow to interpret it as a biogas plant setup cost
Average-size household biodigesterUS$500–US$800 upfront costAfrican household systems; IEA report published in 2020, citing 2019 researchA historical benchmark for basic household digestion, not a heated UK system or electricity-generating plant.
Farm-based AD plant with approximately 500 kW electrical generating capacity£2 million–£4 millionNorthern Ireland; Audit Office report published in 2020A historical project-cost range affected by connection costs, location, feedstocks and building requirements.
Agricultural-feedstock AD biomethane plant producing 20 GWh annually€11.43 million capital costIrish assessment published in 2025; expressed in 2023 pricesA modelled plant benchmark, not a quotation for a particular UK site.
Agricultural-feedstock AD biomethane plant producing 40 GWh annually€19.04 million capital costIrish assessment published in 2025; expressed in 2023 pricesA larger modelled plant; double the output does not mean double the capital cost.
Food-waste AD biomethane plant producing 15.6 GWh annually€22.17 million capital costIrish assessment published in 2025; expressed in 2023 pricesA food-waste plant model whose scope should be checked against the proposed reception and treatment arrangements.
Industrial food-waste AD biomethane plant producing 51.1 GWh annually€22.43 million capital costIrish assessment published in 2025; expressed in 2023 pricesThis model uses processed food waste, reducing the need for complex pretreatment.

Sources: The household figure comes from the IEA’s 2020 biogas outlook. The 500 kW range appears in paragraph 4.6 of the Northern Ireland Audit Office’s renewable electricity report. The biomethane figures appear in Table 16 of SEAI’s 2025 Comprehensive Heating and Cooling Assessment technical annex.

Note: These figures are indicative published benchmarks, not quotations. There are so many factors at play in every biogas plant project that a dependable budget requires project design, an itemised scope and current supplier and contractor quotations. Ground conditions, feedstock handling, connections, contingency and commissioning can materially change the total. Even a detailed pre-construction estimate remains subject to the risks and terms of the project contracts.

What Does This Mean for a 250–500 kW Farm Plant?

The Northern Ireland benchmark shows that a complete 500 kW AD project belongs in the multi-million-pound investment category, rather than being priced solely from its engine or digester quotation.

However, the £2 million–£4 million range was published in 2020. It should be used as a historical comparison, not advertised as a current UK price. Reprice the equipment, civil works and connections before using it in an investment decision.

Nor should you simply halve the range for a 250 kW plant. The same report explains that 250 kW and 500 kW installations share substantial infrastructure. Smaller plants can therefore have a higher capital cost per kilowatt.

“Finn Biogas – Small Scale and Modular …” from finnbiogas.com and used with no modifications.

What Does This Mean for Food-Waste AD?

For a food-waste facility on a light industrial park, first define annual intake, contamination, reception requirements and the energy route. A location description alone is insufficient to estimate the plant cost.

The food-waste benchmarks above concern biomethane production. They should not be transferred directly to a CHP scheme. Establish the costs of buildings, odour control, depackaging, treatment and digestate handling before comparing alternative energy packages.

What If a Gas Pipeline Runs Beside the Biomethane Site?

A nearby suitable pipeline may reduce the length of the connection route. It does not remove the cost of upgrading, compression, gas-quality monitoring, metering, injection equipment or the operator’s connection requirements.

Use the agricultural biomethane figures as capacity-specific reference points, then obtain a site-specific connection assessment. Do not assume that the published capital-cost figures include every land, network, financing or working-capital requirement of your project.

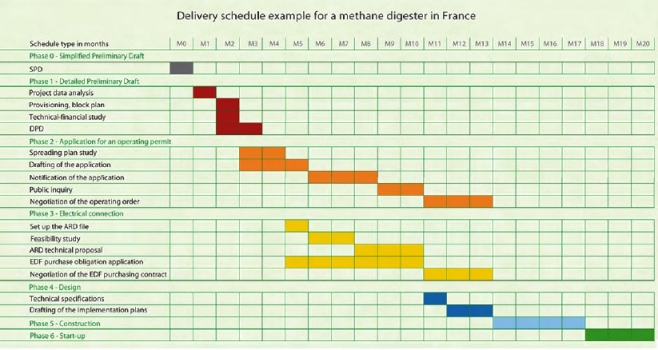

From Published Benchmark to Project Budget

To turn these biogas plant set up cost figures, as provided in the table earlier in this article, into a useful preliminary estimate:

  1. Match the plant type and capacity. Electrical kilowatts, annual biomethane output and digester volume measure different things.
  2. Check the original scope. Identify what the benchmark includes before adding or subtracting costs.
  3. Update the price basis. Obtain current local prices rather than assuming that historical costs remain valid.
  4. Add site-specific requirements. Include abnormal ground works, feedstock infrastructure, digestate storage and confirmed connection costs.
  5. Build the funding schedule. Account separately for contingency, financing, tax cash flows and start-up working capital, avoiding double counting.

The practical answer is a capacity- and scope-specific estimate. Published numbers establish the likely scale of investment; design work and comparable quotations establish the budget for your plant.

Biogas Plant Setup Cost Breakdown

Use the following table as a scope checklist. Some items may already exist at your site; others may require substantial new investment.

Cost categoryTypical scopeWhat to check
Project developmentFeasibility studies, feedstock assessment, site investigations, planning, permitting and professional adviceWhich costs arise before the project is ready for construction?
Land and site preparationLand purchase or lease arrangements, clearance, access and utility diversionsAre land costs and abnormal site works included?
Design and engineeringProcess, civil, structural, mechanical and electrical design; project managementWho designs the interfaces between supplier packages?
Civil worksExcavation, foundations, buildings, roads, drainage, containment and hardstandingDoes the estimate reflect actual ground conditions?
Feedstock reception and preparationStorage, unloading, conveyors, pumps, contaminant removal and any required pretreatmentCan the equipment handle the contracted feedstocks?
Digestion systemDigesters, mixing, heating, insulation, pipework and process instrumentationWhat operating conditions and throughput are guaranteed?
Gas handlingGas storage, condensate management, cleaning, flare and associated safety systemsIs the specification suitable for the chosen gas-use equipment?
Energy utilisationCHP and heat recovery, direct heat equipment, or biomethane upgrading and compressionWhich route to market is included?
Digestate managementStorage, separation, loading, treatment and any required off-site infrastructureIs there sufficient capacity and a viable outlet?
Electrical and controlsPower distribution, control systems, communications, metering and backup arrangementsAre both electricity import and export requirements covered?
Network connectionsElectricity or gas connection works, protection, metering, testing and operator chargesIs there a formal connection offer with defined responsibilities?
Commissioning and handoverTesting, biological start-up, training, documentation and performance demonstrationWho pays for utilities, feedstock and consumables during start-up?
ContingencyAllowance for uncertainty within the defined project scopeDoes the allowance reflect the maturity of the estimate?

Do not assume that every item is included because a quotation is described as “turnkey”. Ask for a written inclusions, exclusions and responsibilities schedule.

CapEx, Operating Costs and Total Project Funding

Capital expenditure (CapEx) generally covers the assets and eligible development costs required to bring the plant into service. The precise accounting treatment should be agreed with your financial advisers.

Operating expenditure (OpEx) includes recurring costs such as staffing, feedstock purchases, electricity, maintenance, consumables, insurance and digestate transport or treatment.

Total project funding must also address cash needed before the plant generates dependable income. This can include financing costs, tax-related cash requirements, commissioning expenditure and initial working capital.

A practical funding schedule therefore considers:

  • development and installed-plant expenditure;
  • connection and owner-supplied costs;
  • an appropriate contingency allowance;
  • financing and tax cash-flow requirements; and
  • cash needed through commissioning and the production ramp-up.

Keep these items visible and avoid counting the same expense twice. A supplier may include commissioning labour while excluding the electricity, inoculum and feedstock used during commissioning.

“Planning of a biogas plant” from www.biogas-renewable-energy.info and used with no modifications.

How to Plan a Biogas Plant Project

1. Establish the Feedstock Supply

Start with the material available, rather than a preferred generator size. Record feedstock quantities, seasonal variation, composition, contamination, storage requirements and delivery arrangements.

For commercial projects, assess the strength and duration of supply contracts. A plant designed around an uncertain waste stream may require additional processing equipment or fail to achieve its intended output.

Use representative sampling and appropriate testing to support methane-yield assumptions. Distinguish laboratory potential from the performance expected under real operating conditions.

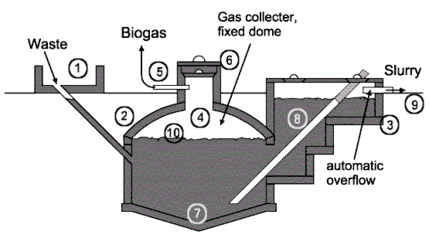

“Fixed-dome Biogas Plants – energypedia” from energypedia.info and used with no modifications.

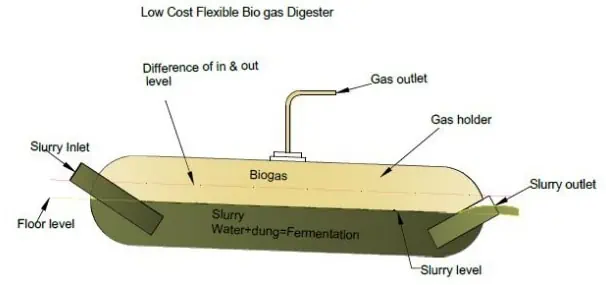

2. Select the Energy Route

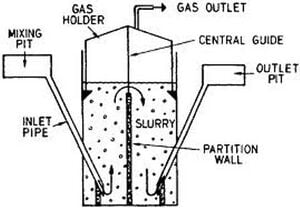

Decide whether the project will supply heat, generate electricity through combined heat and power, upgrade biogas to biomethane, or use another defined route.

The choice affects equipment, connections, energy consumption, revenue and project timing. For CHP, assess how much useful heat can actually be used. For biomethane, establish the required gas specification and delivery arrangements.

“Floating drum biogas digestor” from www.appropedia.org and used with no modifications.

3. Confirm the Site and Digestate Outlet

Investigate ground conditions, access, drainage, utilities, neighbouring land uses and space for future maintenance or expansion.

Plan digestate management at the same time as feedstock supply. Storage, transport, treatment and the availability of suitable outlets can materially affect both setup and operating costs.

4. Develop the Design Basis

A design basis should state the feedstocks, throughput, expected gas production, operating regime, storage capacities and energy output. It should also define the plant’s availability assumptions and the interfaces between equipment packages.

This gives suppliers a common specification against which to quote. Without it, apparently competing offers may describe substantially different plants.

“Balloon Digester – Build a Biogas Plant …” from www.build-a-biogas-plant.com and used with no modifications.

5. Obtain Comparable Quotations and Connection Offers

Seek prices against the same scope. Identify exclusions, owner responsibilities, performance guarantees and the conditions attached to each offer.

Once the budget and project scope are established, use our Biogas Plant Construction Guide for the practical construction and installation sequence.

Types of Revenue Work Investigating when Planning Anaerobic Digestion Projects.

“Project Planning and Financing | US EPA” from www.epa.gov and used with no modifications.

Three Commercial Biogas Project Examples

The examples below illustrate how project scope changes. They are planning scenarios, not supplier quotations or completed-project cost benchmarks.

Example 1: A 250–500 kW Farm-Scale CHP Plant

Here, 250–500 kW refers to the CHP unit’s electrical rating. It does not, by itself, define the necessary digester volume or feedstock throughput.

The budget may include feedstock reception, slurry and solid-feed systems, digesters, heating and mixing, gas storage and cleaning, a CHP package, heat distribution, digestate storage and an electricity connection.

Existing farm infrastructure can help, but its suitability must be verified. A slurry store, access road or electrical supply should not be credited as a saving until its capacity, condition and intended use have been checked.

The main questions are:

  • Can the farm provide enough suitable feedstock throughout the year?
  • Will additional feedstocks need to be purchased or transported?
  • How much CHP heat has a dependable use?
  • What electrical export capacity is available?
  • How much additional digestate storage is required?

A budget based only on the CHP unit and digester price will miss important costs.

Example 2: Food-Waste AD on a Light Industrial Park

A food-waste plant should be defined by its annual intake, waste characteristics and energy route. A light industrial location may offer useful access and utilities, but does not automatically provide the required permissions or infrastructure.

Compared with a relatively simple farm feed system, the scope may include enclosed reception, odour control, depackaging, contaminant removal, buffer storage, washdown facilities and additional wastewater management. Feedstock-specific treatment requirements must also be established.

Budget drivers include:

  • the quantity and type of packaging and contamination;
  • delivery peaks and required reception capacity;
  • odour and noise management;
  • site drainage and wastewater disposal;
  • digestate quality and available outlets; and
  • the cost of adapting an existing industrial site.

Gate-fee income belongs in the financial model. It should not be used to conceal missing capital-cost items or uncertain operating expenses.

Example 3: Biomethane with a Gas Pipeline Beside the Site

Assume that a potentially suitable natural gas pipeline runs beside the proposed AD site. This may shorten the physical connection route, but the connection still needs technical assessment, commercial agreements and an agreed delivery programme.

In addition to the AD process, consider upgrading, gas conditioning, compression, metering, quality monitoring, injection equipment, communications and connection works. The division of responsibility between the developer and network operator must be explicit.

Ask the operator to confirm:

  • the network and connection point;
  • the acceptable injection flow and pressure;
  • any seasonal or operational constraints;
  • gas-quality and monitoring requirements;
  • equipment ownership and maintenance responsibilities; and
  • the approvals, tests and agreements required before injection.

A nearby pipeline is an opportunity to investigate, not a completed connection agreement. The plant will also need electricity for process equipment, upgrading and other site loads.

UK Electricity and Biomethane Connections

UK developers often refer generally to a “National Grid connection”. Identify the actual operator early, because electricity distribution, electricity transmission, gas distribution and gas transmission are separate systems.

Electricity Connections

For a distribution-connected CHP project, work with the relevant distribution network operator on the proposed generation and export arrangements. Investigate import capacity as well as export capacity.

Protection, metering, network works and commissioning requirements should be included in the programme and cost estimate. The Energy Networks Association’s Distributed Generation Guide provides an introduction to the connection process.

Biomethane Connections

Establish whether the proposed connection is to a regional gas distribution network or the National Transmission System. National Gas explains the distinction and its transmission connection process.

Do not transfer the equipment assumptions for one network to another. For example, National Gas states that its direct biomethane connections to the National Transmission System do not require propanisation or odorisation. Distribution-network requirements must be confirmed with the relevant operator.

Allow for Connection Delays

A physically completed plant may still be waiting for connection works, testing, agreements or permission to operate. Model the financial effect of a later start to energy sales.

Potential consequences include additional financing costs, retained staff and contractor costs, insurance, utilities and delayed revenue. Use project-specific programme assumptions rather than a universal allowance for connection time.

The Costs Developers Commonly Underestimate

Ground Conditions and Civil Works

Ground investigations may reveal weak soils, groundwater, contamination or other conditions requiring more extensive foundations and site works. Budget drainage, containment, access and utility diversions alongside the tanks and buildings.

Feedstock Storage and Handling

Handling systems must cope with delivery patterns and real material characteristics. Fibrous, abrasive, contaminated or packaged feedstocks can require different equipment from a clean, pumpable slurry.

Storage should accommodate operational needs and seasonal variation. Undersized reception or storage can constrain a plant even when the digester has sufficient capacity.

Digestate Storage and Disposal

Do not assume that digestate will always leave the site immediately or generate a saleable-product income. Establish storage needs, quality requirements, transport arrangements and outlet costs.

Commissioning and Production Ramp-Up

Equipment commissioning and biological start-up are related but distinct activities. Allow for training, testing, process stabilisation and the period before dependable output is achieved.

Contingency and Scope Gaps

Contingency should reflect the uncertainty remaining in the estimate. An early concept with limited site information needs a different approach from a detailed design supported by firm quotations.

Known omitted items should be added to the budget directly. Contingency is not a substitute for an incomplete scope.

How to Compare Biogas Plant Cost Figures

For every benchmark or quotation, record its price year, currency, country, capacity and inclusions.

  • Cost per kW electrical: distinguish gross generator rating from net export capacity and confirm whether the whole AD facility is included.
  • Cost per tonne of annual intake capacity: define the feedstock and throughput assumptions. This measures installed capacity, not annual operating cost per tonne.
  • Cost per normal cubic metre per hour of biomethane capacity: state the gas reference conditions and whether the figure covers upgrading alone or the complete project.
  • Cost per cubic metre of digester volume: use cautiously. Tank volume does not describe feedstock preparation, energy equipment or the rest of the plant.

A “1,000 cubic metre biogas plant” is particularly ambiguous. Does it mean digester volume, daily raw-biogas output or daily biomethane output? Clarify the unit before discussing price.

A HomeBiogas Plant design for a single family residence.

“How To Make Biogas at Home – A Step-by …” from www.homebiogas.com and used with no modifications.

What About Home Biogas Plant Costs?

Household systems need a separate comparison. A simple unheated digester supplying cooking gas has a different scope from a heated commercial plant generating electricity or exporting biomethane.

For a home system, compare local installed quotations covering the digester, gas storage, pipework, suitable appliances, site works and installation. Check the expected performance under local temperatures and available feedstock.

For technology-specific information, see our Fixed Dome Biogas Plant Design and Installation Guide.

Biogas Plant Set Up Cost and Profit: Test the Business Case

A lower setup cost does not automatically produce a better investment. Financial performance depends on dependable output, operating costs and the terms under which energy, waste-treatment services or other products are sold.

Model the relevant revenue and savings alongside staffing, feedstock, maintenance, utilities, consumables and digestate costs. Include realistic downtime and major equipment replacements.

Test what happens if capital expenditure rises, energy sales start later, output falls, feedstock terms change or digestate handling becomes more expensive. Avoid claiming a standard payback period for every biogas plant.

Biogas plant project planning and biogas plant setup cost - Ai generated view of an AD facility during construction.

Biogas Plant Setup Cost FAQs

Does a digester quotation include the whole plant?

Not necessarily. It may exclude civil works, feedstock reception, energy equipment, connections, digestate storage and development costs. Obtain a written scope schedule.

Is biomethane always more expensive than CHP?

There is no universal answer. Biomethane requires upgrading and delivery equipment, while CHP requires electricity-generation equipment and any heat distribution system. Compare complete schemes biogas plant setup cost with an equivalent capacity and clearly defined scope.

Can I estimate a 500 kW plant by doubling a 250 kW quotation?

That is not a reliable method. Some costs are shared or partly fixed, while storage, reception, civil works and connections may change in steps. Obtain a revised design and quotation.

Will a nearby gas pipeline make injection straightforward?

It may reduce the biogas plant setup cost connection distance, but suitability, capacity, pressure, gas quality, agreements and commissioning must still be confirmed with the operator.

What is the best next step before requesting prices?

Prepare a short design brief covering the site, feedstocks, throughput, energy route, storage needs, connection status and required scope. Ask suppliers to quote against that common brief.

A credible biogas plant budget starts with a defined project. Establish the feedstock, energy route, site conditions, digestate outlet and connection requirements, then obtain comparable quotations. This provides a much stronger basis for investment than a headline digester price or an unexplained cost-per-kilowatt figure.

[Published 17 December 2025. Rewritten with new prices October 2026.]

Tags:
Previous Post
Featured image with the text: Seaweed Anaerobic Digestion Can Beach Strandings Be Turned into Biogas.
Anaerobic Digestion Digester Silage Feedstocks

Seaweed Anaerobic Digestion: Can Beach Strandings Be Turned into Biogas?

Next Post
AD Pumps for Anaerobic Digestion Featured Image.
AD Pumps Anaerobic Digestion

AD Pumps for Anaerobic Digestion: Landia Pumps, Mixers and Biogas Applications

Leave a Reply

Your email address will not be published. Required fields are marked *

This site uses Akismet to reduce spam. Learn how your comment data is processed.

Biogas Production ebook horizontal banner ad.
This website "seen on" Banner.
